A public accounting firm requires the following activities for an audit: Activity Immediate Predecessor Activity time...

A public accounting firm requires the following activities

for an audit:

Activity

Immediate Predecessor

Activity time

A

-

3

B

A

2

C

-

5

D

B, C

2

E

A

4

F

B, C

6

G

E, D

5

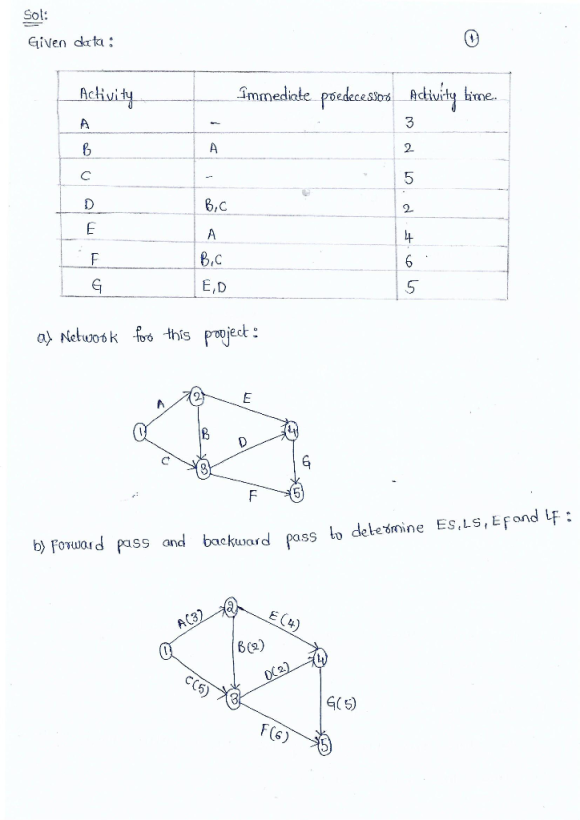

  1. Draw a network for this project? (Marks 0.5)

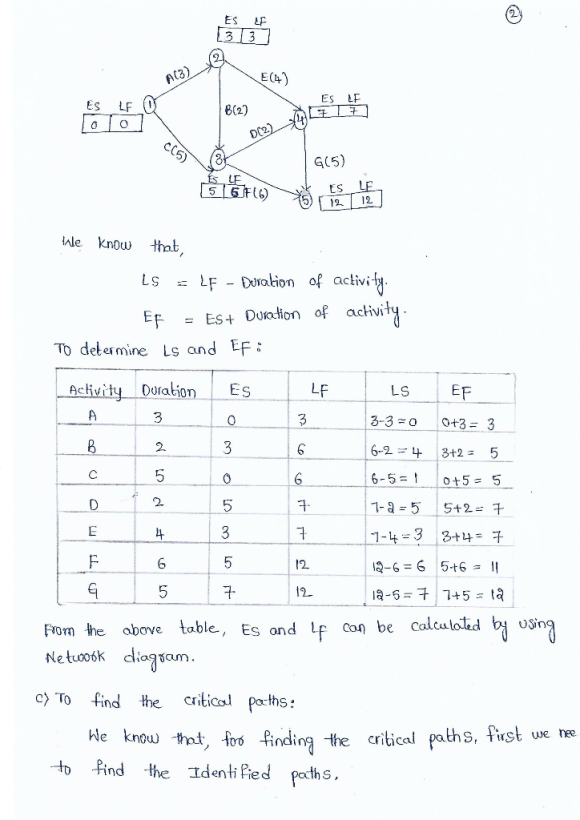

  2. Make a forward pass and a backward pass to determine ES, LS, EF, and LF? (Marks 0.5)

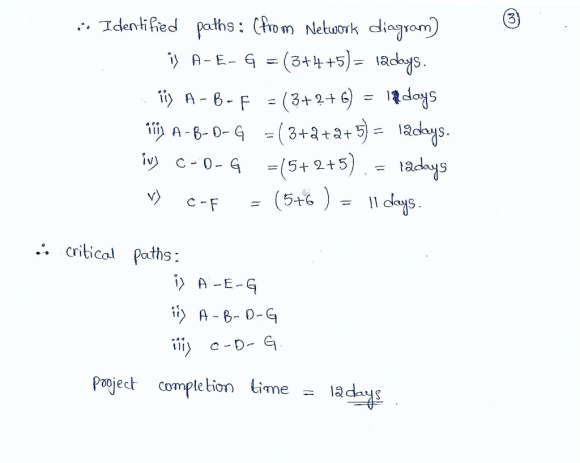

  3. What are the critical path? (Marks 0.5)

Solutions

Expert Solution


Related Solutions

Information on a project’s activities is shown in the following table: Activity Immediate Predecessor Activity Time...
Information on a project’s activities is shown in the following table: Activity Immediate Predecessor Activity Time (wks) Total Budgeted Cost A - 4 24,000 B - 3 27,000 C B 2 14,000 D A 8 32,000 E D 3 24,000 F C, E 4 60,000 G D 6 30,000 H F 6 30,000 I G 4 20,000 J G, H 3 18,000 K I 2 10,000 L J 4 16,000 Create a Gantt chart based on earliest start times. (20...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s)...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s) A 55 55 77 long dash— H 44 44 66 ​E, F B 11 22 55 long dash— I 22 77 1010 ​G, H C 55 55 55 A J 22 44 77 I D 44 88 1313 A K 66 1010 1313 I E 11 1010 1717 ​B, C L 22 66 66 J F 11 55 77 D M 22 22 33...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s)...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s) A 55 55 77 long dash— H 44 44 66 ​E, F B 11 22 55 long dash— I 22 77 1010 ​G, H C 55 55 55 A J 22 44 77 I D 44 88 1313 A K 66 1010 1313 I E 11 1010 1717 ​B, C L 22 66 66 J F 11 55 77 D M 22 22 33...
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR...
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 7 B A 6 C A 2 D C 4 E B, D 3 F D 4 G E F 6 a. Draw the network (20 points) b. What is the critical path? c. How many weeks will it take to complete the project ? d. Identify the early start, early finish, late start, and late finish for each activity...
Suppose there are 8 activities in your project with the following information. Activity Immediate Predecessor Processing...
Suppose there are 8 activities in your project with the following information. Activity Immediate Predecessor Processing Time (days) Processing Cost ($ per day) A B 5 20 B - 4 40 C A,B 6 30 D A 7 10 E C,D 6 25 F C 5 40 G E,F 4 25 H F 3 50 What is the total project lead time? a.) 40 b.)26 c.) 23 What activity is not part of the critical path? a.) activity E b.)...
1) Consider the network corresponding to the following information. Activity Immediate Predecessor(s) Time (Weeks) A ---...
1) Consider the network corresponding to the following information. Activity Immediate Predecessor(s) Time (Weeks) A --- 3 B --- 4 C A 6 D B 9 E B 6 F C, D 6 G D, E 8 H G, F 9 Draw the network corresponding to the above information. Using a table format, identify the critical path. What is the project completion time?
Activities, predecessors and duration for a School Building Project Activity Description Immediate predecessor Duration (days) A...
Activities, predecessors and duration for a School Building Project Activity Description Immediate predecessor Duration (days) A Clear Site and mobilize labour and equipment None 5 B Excavate foundation A 15 C Procure materials (sand, cement, chippings etc.) A 10 D Pour foundation concrete B, C 5 E Mould sandcrete blocks (substructure) C 5 F Construct substructure block work D, E 15 G Construct superstructure block work F, H 30 H Make doors and window frames I 10 I Procure and...
Activity Normal Time (days) Normal Cost ($) Crash Time (days) Crash Cost ($) Immediate Predecessor(s) A...
Activity Normal Time (days) Normal Cost ($) Crash Time (days) Crash Cost ($) Immediate Predecessor(s) A 6 1,000 5 1,200 — B 4 800 2 2,000 — C 3 600 2 900 A, B D 2 1,500 1 2,000 B E 6 900 4 1,200 C, D F 2 1,300 1 1,400 E G 4 900 4 900 E H 4 500 2 900 G The Advanced Tech Company has a project to design an integrated information database for a...
A project has the following activities, precedence relationships, and time estimates in weeks: ​ Activity Immediate...
A project has the following activities, precedence relationships, and time estimates in weeks: ​ Activity Immediate Predecessor Activities Optimistic Time (to) Most Likely Time (tm) Pessimistic Time (tp) A — 15 20 25 B — 8 10 12 C A 25 30 40 D B 15 15 15 E B 22 25 27 F E 15 20 22 G D 20 20 22 ​ a.   Compute the expected time and variance for each activity. b.   Determine the critical path and the expected...
Use the project description presented in the table below for the following questions: Activity Immediate Predecessor...
Use the project description presented in the table below for the following questions: Activity Immediate Predecessor Optimistic Time (O.T.) Most likely Time (M.T.) Pessimistic Time (P.T.) A None 4 6 9 B A 3 5 7 C A 4 7 12 D B 4 8 10 E C 5 9 15 F D 4 4 5 G D, E 3 6 8 H F 5 6 10 I G 5 8 11 J H, I 5 5 5 Calculate the...
