Hawkins Corporation began construction of a motel on March 31,
2018. The project was completed on April 31, 2019. No new loans
were required to fund construction. Hawkins does have the following
two interest-bearing liabilities that were outstanding throughout
the construction period:
$4,000,000, 6% note
$16,000,000, 10% bonds
Construction expenditures incurred were as follows:
March 31, 2018
$4,000,000
June 30, 2018
6,000,000
November 30, 2018
1,800,000
February 28, 2019
3,000,000
The company's fiscal year-end is December 31.
Required:

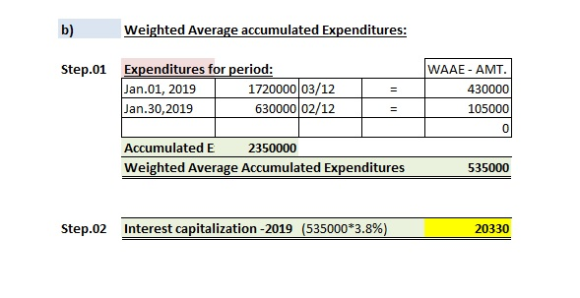

Calculate the...
