Question

In: Operations Management

You are given the following table Activity a m b Immediate Predecessor A 2 5 8...

You are given the following table

Activity

a

m

b

Immediate Predecessor

A

2

5

8

-

B

5

7

9

-

C

2

4

6

-

D

1

2

3

A

E

1

4

7

C

F

3

6

9

B,D,E

G

1

5

9

F

H

1

2

3

F

I

2

5

8

G,H

  1. Draw an AON network based on the given table
  2. Determine the expected time for each activity
  3. Calculate the ES, EF, LS, LF for each activity
  4. Determine the CPM
  5. What is the probability of finishing the project in 26 and 28 weeks?

Solutions

Expert Solution

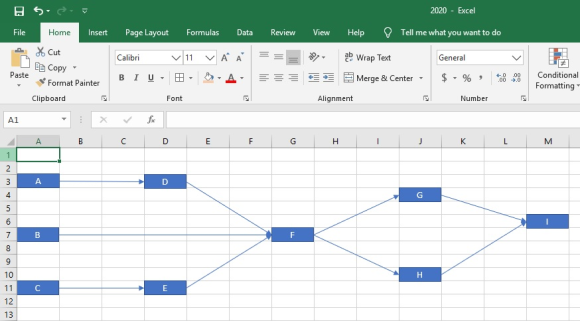

Below is the screenshot of the network -

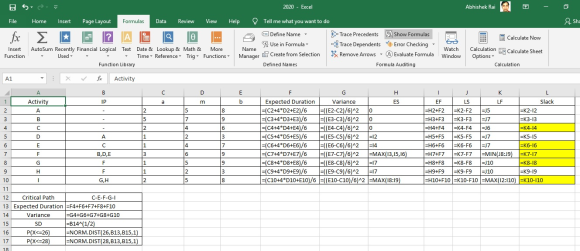

Below is the screenshot of the formula applied -

Below is the screenshot of the result -


Related Solutions

Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s)...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s) A 55 55 77 long dash— H 44 44 66 ​E, F B 11 22 55 long dash— I 22 77 1010 ​G, H C 55 55 55 A J 22 44 77 I D 44 88 1313 A K 66 1010 1313 I E 11 1010 1717 ​B, C L 22 66 66 J F 11 55 77 D M 22 22 33...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s)...
Time​ (days) Immediate Time​ (days) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s) A 55 55 77 long dash— H 44 44 66 ​E, F B 11 22 55 long dash— I 22 77 1010 ​G, H C 55 55 55 A J 22 44 77 I D 44 88 1313 A K 66 1010 1313 I E 11 1010 1717 ​B, C L 22 66 66 J F 11 55 77 D M 22 22 33...
Information on a project’s activities is shown in the following table: Activity Immediate Predecessor Activity Time...
Information on a project’s activities is shown in the following table: Activity Immediate Predecessor Activity Time (wks) Total Budgeted Cost A - 4 24,000 B - 3 27,000 C B 2 14,000 D A 8 32,000 E D 3 24,000 F C, E 4 60,000 G D 6 30,000 H F 6 30,000 I G 4 20,000 J G, H 3 18,000 K I 2 10,000 L J 4 16,000 Create a Gantt chart based on earliest start times. (20...
Use the project description presented in the table below for the following questions: Activity Immediate Predecessor...
Use the project description presented in the table below for the following questions: Activity Immediate Predecessor Optimistic Time (O.T.) Most likely Time (M.T.) Pessimistic Time (P.T.) A None 4 6 9 B A 3 5 7 C A 4 7 12 D B 4 8 10 E C 5 9 15 F D 4 4 5 G D, E 3 6 8 H F 5 6 10 I G 5 8 11 J H, I 5 5 5 Calculate the...
Suppose there are 8 activities in your project with the following information. Activity Immediate Predecessor Processing...
Suppose there are 8 activities in your project with the following information. Activity Immediate Predecessor Processing Time (days) Processing Cost ($ per day) A B 5 20 B - 4 40 C A,B 6 30 D A 7 10 E C,D 6 25 F C 5 40 G E,F 4 25 H F 3 50 What is the total project lead time? a.) 40 b.)26 c.) 23 What activity is not part of the critical path? a.) activity E b.)...
A public accounting firm requires the following activities for an audit: Activity Immediate Predecessor Activity time...
A public accounting firm requires the following activities for an audit: Activity Immediate Predecessor Activity time A - 3 B A 2 C - 5 D B, C 2 E A 4 F B, C 6 G E, D 5 Draw a network for this project? (Marks 0.5) Make a forward pass and a backward pass to determine ES, LS, EF, and LF? (Marks 0.5) What are the critical path? (Marks 0.5)
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR...
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 7 B A 6 C A 2 D C 4 E B, D 3 F D 4 G E F 6 a. Draw the network (20 points) b. What is the critical path? c. How many weeks will it take to complete the project ? d. Identify the early start, early finish, late start, and late finish for each activity...
QUESTION 5 A project has the following activities: Activity Duration, days Predecessor activity A 8 None...
QUESTION 5 A project has the following activities: Activity Duration, days Predecessor activity A 8 None B 7 A C 4 None D 11 C E 7 B & D The project started on Day 1. Assume 7 working days a week. For example, activity A start on Day 1 and finish on the end of day 8. John is responsible for both activities B and D. However, he CAN'T work on both of them on the same period. By...
Activity Predecessor Activity Duration in Weeks A ---- 3 B A 5 C A 7 D...
Activity Predecessor Activity Duration in Weeks A ---- 3 B A 5 C A 7 D B 10 E C 5 F D, E 4 Using the Critical Path Method (CPM), find the critical part, activities, and the date to finish the project (Gantt Chart would help). I would really appreciate excel screenshots!
1) Consider the network corresponding to the following information. Activity Immediate Predecessor(s) Time (Weeks) A ---...
1) Consider the network corresponding to the following information. Activity Immediate Predecessor(s) Time (Weeks) A --- 3 B --- 4 C A 6 D B 9 E B 6 F C, D 6 G D, E 8 H G, F 9 Draw the network corresponding to the above information. Using a table format, identify the critical path. What is the project completion time?
