Given the following project:
|
 Activity  |
 Predecessor  |
 Optimistic (day)  |
 Most Likely (day)  |
 Pessimistic (day)  |
|
 Start  |
 A, B, C  |
 -  |
 -  |
 -  |
|
 A  |
 D  |
 38  |
 50  |
 62  |
|
 B  |
 E  |
 90  |
 99  |
 108  |
|
 C  |
 End  |
 85  |
 100  |
 115  |
|
 D  |
 F  |
 19  |
 25  |
 31  |
|
 E  |
 End  |
 91  |
 100  |
 115  |
|
 F  |
 End  |
 62  |
 65  |
 68  |

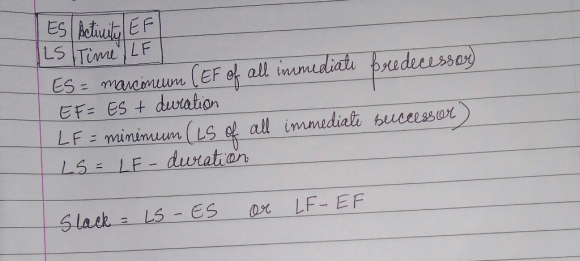

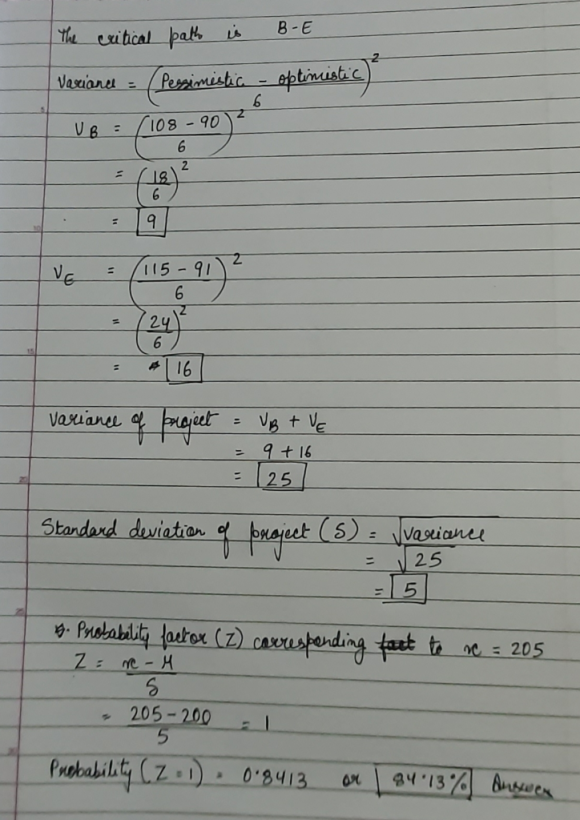

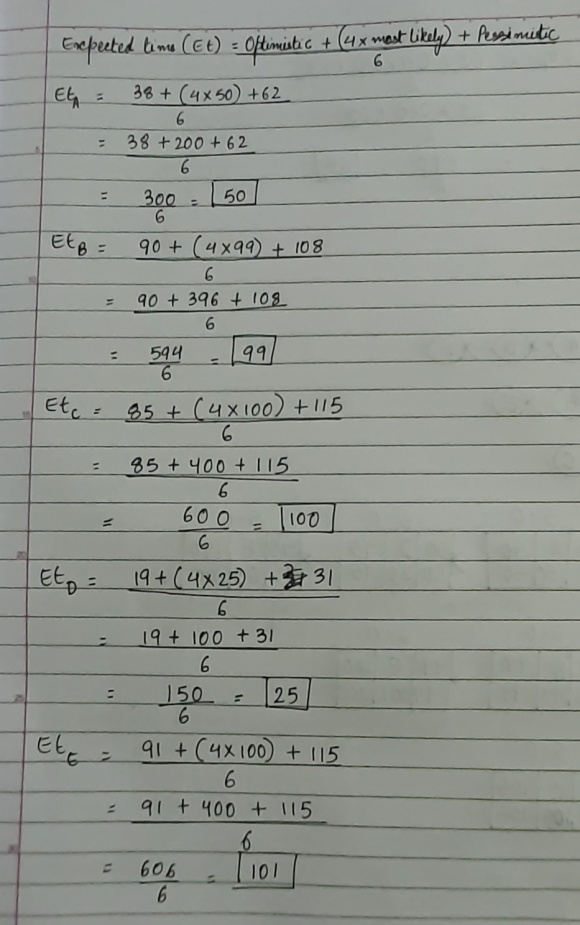

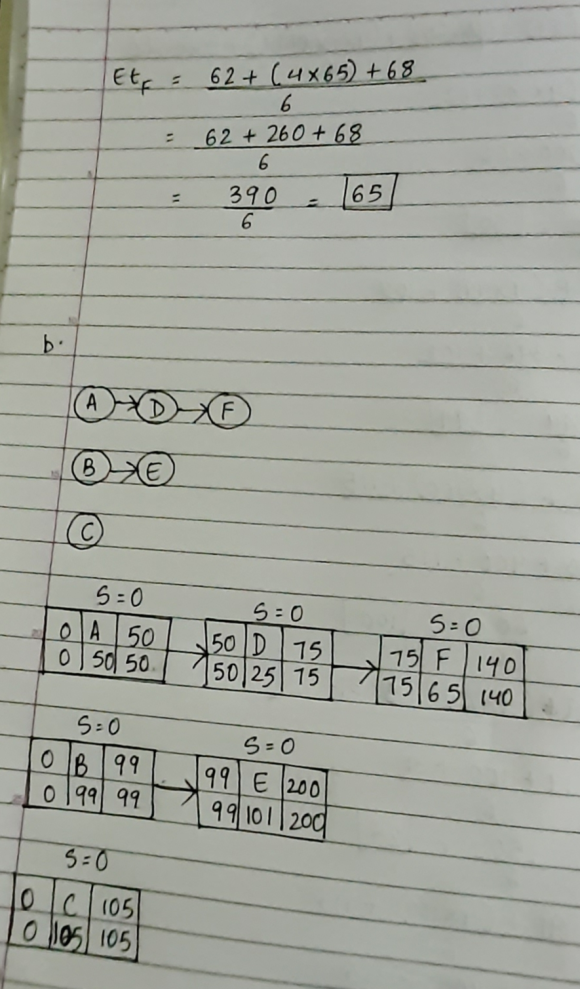

Critical path method (CPM) is a step-by-step process by which critical and non-critical tasks are defined so that time-frame problems and process bottlenecks are prevented.
