Question

In: Accounting

Question 25 On February 1, 2017, Marsh Contractors agreed to construct a building at a contract...

Question 25

On February 1, 2017, Marsh Contractors agreed to construct a building at a contract price of $5,940,000. Marsh estimated total construction costs would be $4,112,000 and the project would be finished in 2019. Information relating to the costs and billings for this contract is as follows:

2017 2018 2019
Total costs incurred to date $1,542,000 $2,724,000 $4,670,000
Estimated costs to complete 2,570,000 1,816,000 -0-
Customer billings to date 2,340,000 4,112,000 5,740,000
Collections to date 2,140,000 3,640,000 5,640,000


Fill in the correct amounts on the following schedule. For percentage-of-completion accounting and for completed-contract accounting, show the gross profit that should be recorded for 2017, 2018, and 2019.

Solutions

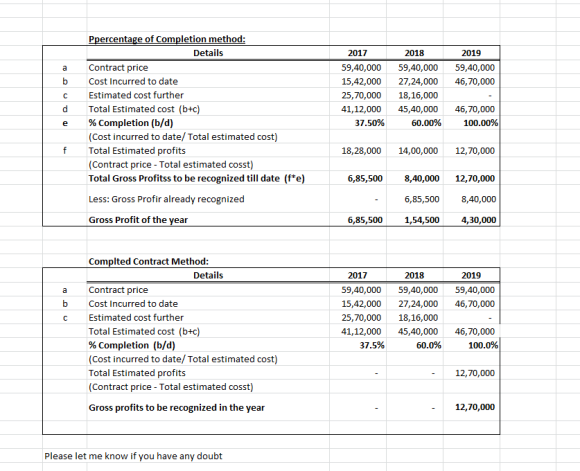

Expert Solution
