In: Operations Management
The demand for subassembly S is
110
units in week 7. Each unit of S requires
2
unitss
of T and
1
unitnothing
of U. Each unit of T requires
1
unitnothing
of V,
2
unitss
of W, and
1
unitnothing
of X. Finally, each unit of U requires
1
unitnothing
of Y and
2
units of Z. One firm manufactures all items. It takes 2 weeks to make S,
2
weekss
to make T, 2 weeks to make U,
1
weeknothing
to make V,
2
weeks to make W,
2
weekss
to make X, 2 weeks to make Y, and
2
weekss
to make Z.
LOADING...
Click the icon to view the product structure and the time-phased product structure.
In addition to
110
units of S, there is also a demand for
20
units of U, which is a component of S. The
20
units of U are needed for maintenance purposes. These units are needed in week 6. Modify the gross material requirements plan to reflect this change (type 0 if the input box is not used).
Week |
Lead Time |
||||||||
Item |
1 |
2 |
3 |
4 |
5 |
6 |
7 |
(weeks) |
|
S |
Gross req |
0 |
0 |
0 |
0 |
0 |
0 |
110 |
|
Order release |
0 |
0 |
0 |
0 |
110 |
0 |
0 |
2 |
T |
Gross req |
nothing |
nothing |
nothing |
nothing |
nothing |
nothing |
nothing |
|
Order release |
nothing |
nothing |
nothing |
nothing |
nothing |
nothing |
nothing |
2 |

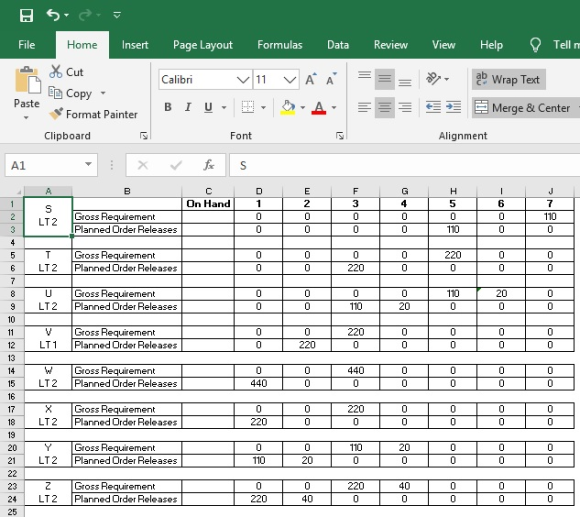

Below is the screenshot of the MRP schedule -

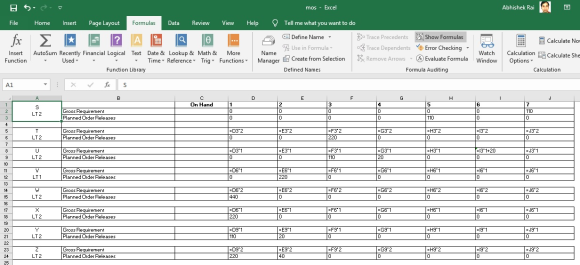

Below is the screenshot of the formula applied -
