In: Operations Management
Plan
E:
Keep the current workforce, which is producing
1 comma 6001,600
units per month, and subcontract to meet the rest of the demand. Subcontract cost is
$7575
per unit. Subcontracting capacity is limited to
500500
units per month. The warehouse and overtime constraints from Plan D do not apply to this plan.
|
 Plan E  |
|||||||
|
 Month  |
 Demand  |
 Production (Units)  |
 Subcontract (Units)  |
 Ending Inventory  |
|||
|
 0  |
 December  |
 200200  |
|||||
|
 1  |
 January  |
 1 comma 4501,450  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 2  |
 February  |
 1 comma 6001,600  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 3  |
 March  |
 1 comma 7001,700  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 4  |
 April  |
 1 comma 7001,700  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 5  |
 May  |
 2 comma 1002,100  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 6  |
 June  |
 2 comma 1002,100  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 7  |
 July  |
 1 comma 9001,900  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
|
 8  |
 August  |
 1 comma 3001,300  |
 1 comma 6001,600  |
 nothing  |
 nothing  |
||
The total subcontracting cost= $nothing (Enter your response as a whole number)
The total inventory holding cost for January through August = $nothing
The total cost excluding normal time labour costs, Plan E= $nothing

Below is the screenshot of the formula applied -

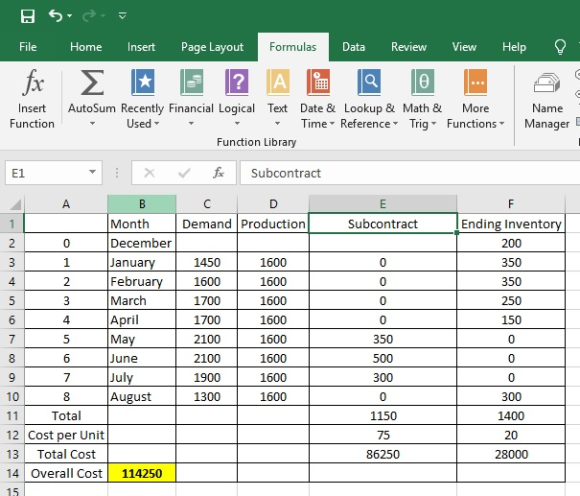

Below is the screenshot of the result -

Subcontract Cost = 86250
Holding cost = 28000
Total Cost = 114250
