In: Operations Management
Given the following project: 1. Develop a time limited resource profile chart assuming unlimited resource availability. That is, determine the resource requirement on a weekly basis if the project is to be completed in the minimum time. 2. Develop a resource-constrained schedule using the sequential heuristic.
Activity |
Predecessor |
Duration (week) |
Required No. of Workers |
1 |
- |
3 |
2 |
2 |
- |
2 |
1 |
3 |
2 |
3 |
2 |
4 |
2,5 |
4 |
2 |
5 |
1 |
4 |
1 |
6 |
3,4,1 |
3 |
1 |
7 |
3 |
4 |
2 |
8 |
5 |
3 |
1 |
Assume the followings:
The available resource is three units

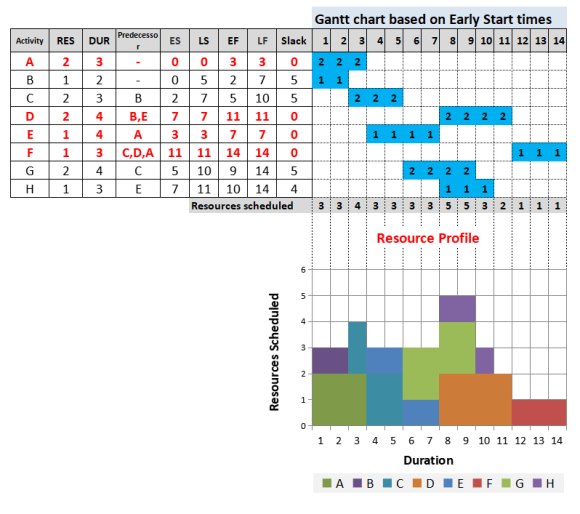

Time-limited resource profile is as follows:
---------------------------------------------------
In the original schedule, we see that resource requirement in period 3, 8, and 9 exceeds the available resources (3). Therefore, activities C and G are rescheduled.
Resulting resource-constrained schedule is as follows:
