The table below shows the net weekly demand of Audi Car model. The lead time to receive the door is 2 weeks. In week 0, there are 5 cars and 15 doors in inventory. It is expected to receive 30 reworked doors in week 10.
|
 Week  |
 8  |
 9  |
 10  |
 11  |
 12  |
 13  |
 14  |
 15  |
 16  |
 17  |
|
 Net demand (car)  |
 20  |
 25  |
 40  |
 12  |
 5  |
 32  |
 24  |
 18  |
 16  |
 30  |

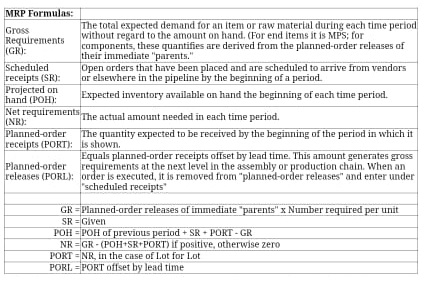

Complete the following MRP table for the doors:
|
 Week  |
 1  |
 2  |
 3  |
 4  |
 5  |
 6  |
 7  |
 8  |
 9  |
 10  |
 11  |
 12  |
 13  |
 14  |
 15  |
 16  |
 17  |
|
 Gross Requirement  |
|||||||||||||||||
|
 Net Requirement  |
|||||||||||||||||
|
 Time-Phased Net Requirement  |
|||||||||||||||||
|
 Planned Order Release  |
